资源描述
DATACOM
Information Technology Limited
WELCOME
TO
项目管理
PROJECT TEAM
MEMBER WORKSHOP
A TWO DAY WORKSHOP
This workshop has been specifically designed to help you understand the essential principles of project management as a member of a project team and introduce you to a consistent process for managing any type of Project in the Organization. The process is an integral part of the PROGRAM METHODOLOGY. Our objective is to ensure all programs and projects are effectively managed and reviewed to achieve success and delight our customers every time with on-time completion.
The workshop includes a case study to give you an opportunity to apply the techniques included in the methodology

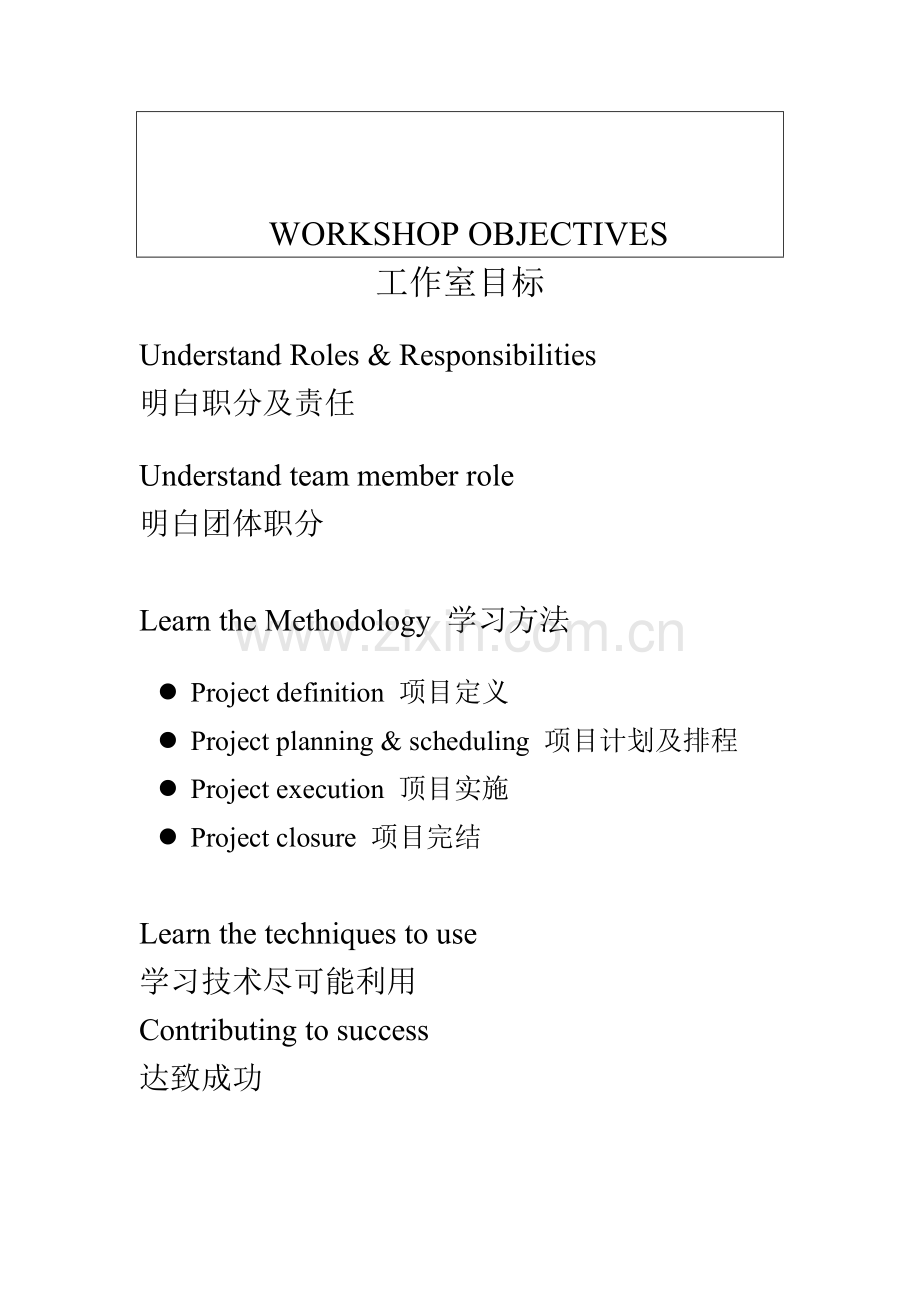

WORKSHOP OBJECTIVES
工作室目标
Understand Roles & Responsibilities
明白职分及责任
Understand team member role
明白团体职分
Learn the Methodology 学习方法
l Project definition 项目定义
l Project planning & scheduling 项目计划及排程
l Project execution 顶目实施
l Project closure 项目完结
Learn the techniques to use
学习技术尽可能利用
Contributing to success
达致成功
ESTIMATING FACTORS
估量原因
TASK
使命
SIZE EFFORT DURATION=
WORK DAYS
大小 努力 期间=工作日数
CALENDAR TIME
日历时间
EFFORT≠DURATION≠SCHEDULE
努力≠期间≠进度表
INPUTS
输入
Historical data
过往资料
Experience & skills
经验及技巧
Expert view
教授意见
BIAS? BIAS?
偏见? 偏见?
TASK
任務
EFFORT
努力
SIZE 大小
PERSON DAYS
個人日子
DEFINE MEASUREMENT
BASIS 估計定義基礎
其它?原因
OTHER ? FACTORS
EFFORT
努力
ANALYSIS
分析
CAPACITY
容量
WORKLOAD
工作負擔
DURATION
日期
Critical Path Method –PERT
计划评审技术-PERT
S
F
S
F
逻辑基础-依靠性
BASED ON LOGIC-DEPENDENCY
3 TYPES:三种类
l Finish to Start完结到起始
l Start to Start [paired] 起始到起始[配对]
l Finish to Finish [paired]完结到完结[配对]
CRITICAL PATH –THE LONGEST PATH
计划评审-最长要径
-LEAST FLEXIBLE
-最低灵活性
Any slippage extends the Total Project Time [TPT]
任何小疏忽加长总项目时间
CAREFUL: Compressing the schedule
can change the Critical Path
警告:压缩排程能够改变要径
CPM-PERT TERMS
Forward Pass- Early START and FINISH 前进-早开始及完成
Backward Pass-Late START and FINISH 后退-开始及完成
TOTAL FLOAT-摇摆
SPARE TIME IN AN ACTIVITY
分配时间于多种活动
INCLUDES FREE AND INDEPENDENT FLOAT
包含自己反依靠性摇摆
CRITICAL ACTIVITY-ZERO FLOAT BY
关键活动-零摇摆
DEFINITION-IT CAN BE FORCED!定义-能够强行
OTHER RELATIONSHIPS其它关系
4d
LEG [GAP]- A forced delay between tasks
2d
LEAD [LEEWAY]-A forced start of the
successor before completion of the
predecessor
Errors in Logic
BOTH BREAK THE LOGIC
OF THE NETWORK
错误使纲络理论停止运作
THE LOOP 循环
THE DANGLE 摇摆不定
REVIEW THE PROJECT DEFINITION
检讨计划定义
Does the plan: 计划
l meet critical dates for deliverables? 在关键日子传输讯息
l clearly meet interface dates? 清楚相约其它日子
OPTIMISATION INVOLVES: 理想计划包含
l understanding the conflicts 明白冲突地方
l analysing priorities 分析优先次序
l deriving options 削去无须要选择
l selecting the best realistic option 选择最真实性决择
l seeking stakeholder agreement 寻求投资者同意书
l revising plans 重温计划内容
l communicating to everyone 和其它人交换意见
TRADE-OFFS & OPTIMISATION
TAKES TIME TO GET THE BEST
SOLUTION
选择性及乐观性
用时间来获取最好方案
OPTIMISING TRADE-OFFS乐观性选择
POSSIBLE ACTIONS: 可行方法
Re-evaluate dependencies 重新评定依靠性
Review relationships 回顾多种关系
Introduce Lags and Leads-with care! 小心地引申拉引行为
Split activities for concurrency 分散工序,保持合作性
Review duration 检讨各工作时间
Review contingency time检讨一贯时间所需
Re-assign resources 重新分配资源
Utilise the Total Float times 尽可能利用全部空间时间
Reduce peak loading – levering 降低极大压力-平衡
Seek more resources? 寻求更多资源
Increase resource capacities 增加资源地位
Avoid re-invention 预防再发明其它选择
Reduce Scope/specifications? 降低分工合作
EVALUATE THE IMPACT 评定影响所及
Use what-if analysis 假如用作为分析
Review Project Risks 检讨其冒险机会
Customer acceptance 客人接收机会
OPTIMISING & RECOVERY PLANNING INSIDE A KEY STAGE
乐观化及恢复计划是一个关键阶段
DEVELOP WHAT – IF’s 发展空间
REDUCE THE OPTIONS 降低选择机会
RECOMMENDED ACTIONS 推介行动
SEEK PROJECT LEADER
APPROVAL
计划得到组长应允
BEFORE YOU MODIFY THE PLAN
在改变原定计划之前
COMMUNICATE THE PLAN CHANGES TO THOSE DOING
THE PROJECT WORK
向相关工作人员解释新计划改变
SECURE RESOURCE COMMITMENTS
保障资源承诺
The Key Stage Owner 关键阶段拥有些人
The Resource 资源
The Functional Manager 功效组别经理
ALL PARTIES MUST SIGN – UP
PROJECT LEADER APPROVES
参与者必需签署待组长审阅
REVIEW THE RISK LOG
检讨有危机地方
ASK: 问
Have any changed rankling? 何种改变, 使人痛心
Any ,moved to HIGH? 何事转为高危事件
Any risks identified from planning? 何种危机被计划所确定
Check the plan for areas of risk;
检验计划裹有危机地方
Tasks on the Critical path 关键关键时刻
Tasks with long durations 长远计划
Tasks dependent on third parties 依靠第三者
Lags and Leads 落伍及前卫
Complex tasks 繁复工作
Tasks using new technology 新科技应用
Tasks with little float 摇摆不定
Do not remove risks from the LOG, only remove the ranking
不要将风险在日志中除掉,只有除掉次序优先
IDENTIFY ISSUES PROMPTLY
ACTION TO RESOLVE IS A PRIORITY
定时确定危机优先采取行动处理
The Project Leader must record
all issues.
计划组长必需统计全部论点
ISSUES ARE RATED: 论点分类
RED-MAJOR-Escalated to Project Members
红色-关键-扩大到项目人员
YELLOW-SERIOUS-Escalated to Sponsor
黄色-严重-扩大到资助人
GREEN-MINOR-Escalated to Project Leader
绿色-次要-扩大到组长
ACTION PLANS ARE ESSENTIAL
行动关键性
Was it a RISK? 危机
What is the consequence? 结果
What options are available? 可供选择
What actions are recommenced? 提议采取行动
Who is responsible for implementation?谁可实施
SET THE BASELINE PLAN
设定计划底线
‘FIXES’ THE PLAN
固定计划
BASIS OF PROGRESS
量度工作
MEASUREMENT
进度底线
ESTABLISHES CLEARLY
VISIBLE TARGETS
设置清楚可见目标
AGREES A MEETINGS
SCHEDULE
同意会议时间表
ESTABLISHES REPORTING & CHANGE PROCESSES
建立汇报及转变程序
REPORTING PROGRESS 进度汇报
COMMUNICATION IS VITAL TO SUCCESS
人和人沟通是成功原因
KEY STAGE OWNER-
REPORT STATUS AT FREQUENCY
SET BY PROJECT LEADER.
关键阶段段持有些人周期性汇报工作进度由组长设定
FOCUS: 焦点
MILESTONES ACHIEVED 里程碑建造
MILESTONES DELAYED 里程碑延误
ACTIONS TO CORRECT SLIPPAGE 改善散漫态度
FORECAST OF COMPLETION 估计完成日期
ISSUES OUTSTANDING 还未处理议论
ANTICIPATE RISKS & ISSUES
预见危机及论点
THE CHANGE PROCESS 改变程序
Significant changes MUST
be documented and approved
重大改变一定要书面通知,并得到同意
Significant change impacts on:
重大改变会冲击在:
l deliverables传达
l schedule时间表
l costs 成本
l resource loadings 资源分配
l quality 质量
l performance 表现
THE PROJECT CHANGE REQUEST 计划改变
FOCUS ON: 焦点放在
l benefits of change 利益
l impact on cost/schedule/resources影响成本/时间表/资源
l priority 优先权
l increased/reduced risks 增加/降低危机
ORGANISE THE LAUNCH组织一个新开始
VALIDATE & CONFIRM: 有效及确定
l KEY STAGE WORK PLANS 关键階段工作計劃
l RESOURCE COMMITMENTS 資源承諾
l MEETINGS SCHEDULE 會議時間
l 1:1-TEAM MEMBERS & SPONSOR
1:1组员及资助人
l PROJECT TEAM-PROGRESS
工作小组进度
l PROJECT REVIEWS工作检讨
l KEY STAKEHOLDERS 关键投资
THEN HOLD THE:然后抓紧
l THE PROJECT LAUNCH MEETIN新工作會議
The Project Sponsor工程資助人
Key stakeholders 关键投資
The Project Leader 組長
The Team 組員
Monitoring & Tracking Progress
辅助及紧随工作进度
MONITORING 辅助
THE CHECKING PROCESS检验程序
COLLECTING PROGRESS DATA搜集工程数据
QUALITATIVE DATA使之为有质数资料
TEAM PERFORMANCES小组表现
IDENTIFY VARIANCES确定不一样意见
REVIEW RISKS检讨危机
TRACKING 紧随
ANALYSING THE VARIANCE分析各类意见
DEFINING CAUSE寻求原因
ESTABLISHING IMPACT
EVALUATE OPTIONS评定全部选择
PLAN CORRECTIVE ACTIONS计划正确行动
RESOLVE ISSUES处理方案
UPDATE PLAN DOCUMENTS更新多种文件
REPORT PROGRESS汇报进度
COLLECTING PROGRESS DATA搜集工程数据
THE GANTT CHART IS LINEAR统计图表是线形
EFFORT IS .…? 努力是?
Ask: 问
START DATE开始日期
EFFORT EXPENDED TO DATE努力漫延至当日
EFFORT REMAINING努力仍留下
But ALWAYS ask:但通常问?
FORECAST TO COMPLETE估计完成日期
NOT 否
不一样意见VARIANCE
分析ANALYSIS
+ BETTER THAN PLAN
效果比计划好
- WORSE THAN PLAN
效果比计划差
ANALYSE分析
THE CAUSE成因
PROJECT SLIP–ONE DAY AT A TIME!
工作散漫 - 一天一次
ANALYSE CAUSE:分析成因
Fishbone diagrams鱼骨图
Why-Why diagrams点解-点解图
ESTABLISH IMPACT
Re-assign resources重新分配资源
Revise estimates重新估量
New estimator!委任新评定人员
More effort?更新努力
More resource?更多资源
Modify plan logic?更新计划推论
ALWAYS GET OTHERS INVOLVED
IN PROBLEM SOLVING –DON’T TRY
AND DO IT ALONE.
不要依靠其它人帮你处理难题, 让自己处理
PLAN CORRCETIVE ACTION计划正确行动
DEVELOP OPTIONS选择发展
USE TEAM EXPERTISE利用小组经验
RECORD ASSUMPTIONS统计假设
CHECK FOR RISKS检验危险性
SELECT ‘BEST’ OPTION选最好决择
[scope-cost-schedule] 内容-成本-时间表
DON’T SHOOT FROM THE HIP!
SOLVE THE PROBLEM-
NOT THE SYMPTOMS
处理问题并不是问题征兆
CHECK IF:先检验,假如:
- critical path is changed关键性路径改变
- workloads adversely affected影响工作量
- milestones are affected影响里程碑
- new HIGH risks exposed新高危展现
- cost over-runs introduced成本过高
- schedule slippage are controllable工作散漫是可控制
DEVELOP ACTION PLANS:
发展挽救行动计划
- priority order?优先次序
- who is responsible?谁可负责
- target completion date?目标完成日期
- who kept informed?谁可保持联络
ESCALATE OUTSTANDING ISSUES
扩大不能处理论点
VALIDATE COMMUNICATION PROCESSES有效沟通程序
Ensure you maintain effectiveness
确保维持高效率
Report status and issues promptly
定时汇报进度及意见
Attend team meetings on time
按时出席小组会议
Have 1:1’s with Project Leader
Agree your performance targets
认可你表现目标
Anticipate issues
估计其它
Watch for triggers on risks
留心每个引发危机机会
Maintain awareness-new risks
保持清醒面对新危机
UPDATE THE RISK ASSESSMENT
更新危机
Review risks regularly that affect
your key stages
定时检讨各类危机,将可影响你成功
High risks must be alerted to
Project Leader for action planning
高危一定要通知组长采取行动
Review outstanding issues
and their corrective action plans
Highlight unresolved issues
-they do NOT go away!
标识不能处理难题,使之不会遗留
Ensure your assigned ACTIONS
are completed on time
确保你分配工作按时完成
ESTABLISH COMPLETION CRITERIA建立完整標準
DELIVERABLES灌輸性
BENEFITS利益
DECIDE:决定
Which activities/factors哪种行动/原因
How measured怎样量度
S M A R T test机智程度测试
Limits of acceptability有限接收能力
USE THE WBS!利用资询科技
DERIVE A HANDOVER CHECKLIST
设计承继工作检视表
YOUR OBJECTIVE IS TO
DELIGHT YOUR CUSTOMER
你目标是取悦你用户
ACCEPTANCE PROCESS接收程度
DEFINE AS EARLY AS POSSIBLE
IS IT A KEY STAGE IN YOUR PLAN?
在你计划中尽早介定是否相关键时刻
DEFINE:介定
WHO ACCEPTS THE RESULTS?谁接收结果
WHAT DOCUMENTATION?何种书面通知
WHO IS RESPONSIBLE?谁可负责
WHAT SUPPORT?什么形式支持
WHO IS RESPONSIBLE?谁又可负责支援
HOW LONG?需多久
TRAINNING NEEDS?需要训练
HOW SATISFIED? 怎算满意
RECORD IN PROJECT FILE
统计在计划档案
Excellence!尤其出色
COMES FROM
CONTINUOUS IMPROVEMENT
来自不停改良
搜集良好意见COLLECT GOOD IDEAS:
新产品New products
新实施New Processes
新程序New Procedures
DON’T LOSE THEM!不要遗失
ANOTHER PROJECT?第二个工程
RECORD FOR LATER INVESTIGATION
统计最新数据
CLOSE-OUT THE PROJECT暂停现有工程
PROJECT REVIEW MEETING
工程检讨会议
Completion Certificate
完成証書
Documentation文書處理
Acceptance Process接收程序
Action outstanding
Issues 行動
Deliverables
WBS done傳送
Review Issue Log
檢討意見
EVALUATION-WHY?评定点解
WHAT WENT WELL?
什么进行顺利
WHAT WENT BADLY?
什么进行不顺利
WHY?点解
An opportunity for……另一个良机
CONTINUOUS
IMPROVEMENT
不停改良
REVIEW THE PROJECT PROCESS
检讨计划进行
Ask questions:常问题目
What problems occurred?常见问题
How were these identified .. and resolved?怎样确定及处理
Which procedures worked well?哪个程序顺利进行
What improvements can be made now?改良方案可实时实施
What improvements have been made?改良后优点
REVIEW TEAM &
STAKEHOLDER PERFORMANCE
检讨组员及投资者表现
PURPOSE: To learn not blame!
目标去学习不是责备
Review:检讨
- management processes管理进行
- team leadership组长领导能力
- individual performance部分组员表现
- communication processes沟通程况
- team working小组工作
DOCUMENT THE LEARNING POINTS
将学习关键点文件
COMMUNICATE沟通性
GLOBALLY环球性
WHAT ACTION IS NEEDED?需要什么行动?
WHO WILL OWN THE ACTIONS?谁可实施?
WHAT IS THE TARGET DATE TO COMPLETE?
怎样完成指定目标日期
PREPARE THE FINAL REPORT准备结尾汇报
Summary of project performance-概述工程表现
good and ‘not so food’好和不好
+ Results of Evaluation评论结果
+ Recommendations for improvement
推介改善方案
FINAL SIGN-OFF MEETING最终会议
Then然后
CELEBRATE Success庆贺成功
展开阅读全文
